Quick Answer: What Happens Inside a Bedside Table Factory After an OEM Order Is Confirmed?

After an OEM bedside table order is confirmed, the factory first turns the approved product details into a clear production order before workshop production begins. This order guides the team on product size, material, finish, hardware, drawer structure, smart module position if needed, quantity, and delivery schedule.

At Hebai Furniture, a typical bedside table production workflow includes production order release, material preparation, panel cutting, edge banding, drilling and slotting, surface checking, cabinet body assembly, drawer assembly and adjustment, optional smart module installation, in-process checking, cleaning, labeling, and transfer to the packing area.

For B2B buyers, this workflow matters because a good sample is only the beginning. What matters more is whether the factory can repeat the same structure, size, color, drawer movement, hardware position, and finished appearance across a bulk order.

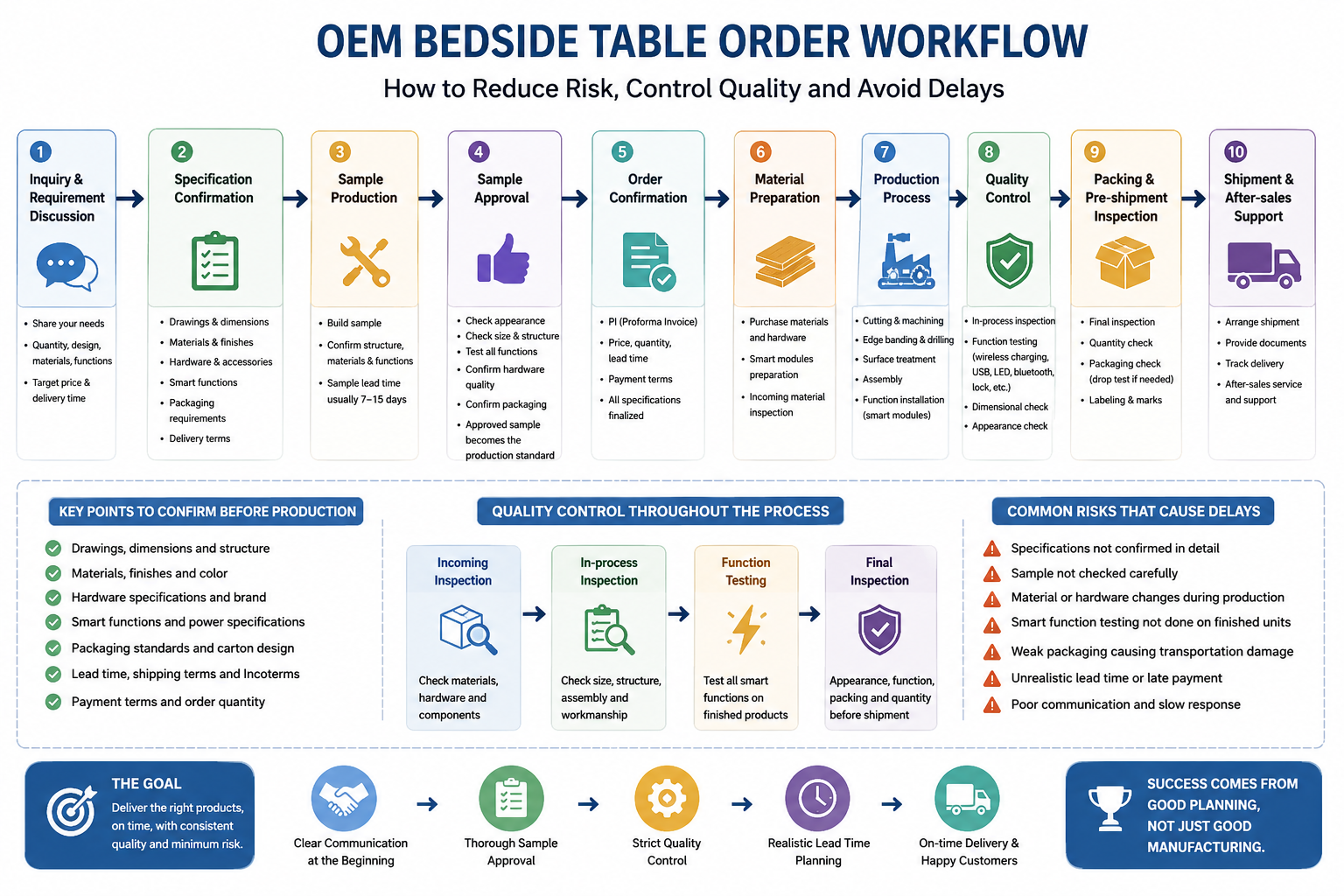

In simple terms, an OEM bedside table moves through three factory stages:

1. Pre-production organization: production order release, material preparation, and workshop scheduling.

2. Workshop manufacturing: cutting, edge banding, drilling, surface handling, cabinet assembly, drawer adjustment, and smart module installation if required.

3. Finished product handover: in-process checking, cleaning, labeling, accessory matching, and transfer to the packing area.

Need a reliable OEM bedside table factory?
Send us your product photo, drawing, size, material, finish, quantity, and target market. Hebai Furniture can review your design and suggest a practical production workflow before mass production.

1. Why We Care About the Production Workflow

When a buyer visits a furniture factory, it is easy to focus on the showroom, samples, and price sheet. These things are important, but they do not tell the full story.

In real OEM production, the most important question is not only:

Can the factory make one good sample?

The more practical question is:

Can the factory make the same product again and again, with stable quality, in the required quantity and delivery time?

This is where production workflow becomes important.

A bedside table looks simple from the outside. It may only have one drawer, two drawers, open storage, metal legs, or a smart charging panel. But once it enters mass production, many details must be controlled: panel size, edge banding, hole position, drawer slide installation, handle position, surface protection, labeling, and product handover.

If the production workflow is not clear, problems usually appear later:

  • the workshop uses the wrong board or finish;

  • hardware is missing when assembly starts;

  • drawer slide holes are not aligned;

  • left and right panels are mixed;

  • the first batch and second batch look slightly different;

  • drawer gaps are not even;

  • finished products wait too long before packing;

  • different SKUs are placed together and cause confusion.

These are not only “quality problems.” Many of them are workflow problems.

China remains a major global furniture export base. OEC data shows that China exported about USD 35.1 billion of HS 9403 “Other Furniture” in 2025, which is why many global buyers continue to evaluate Chinese furniture factories carefully.

At Hebai Furniture, we do not describe production as a perfect line on paper. In a real factory, each order needs communication, checking, adjustment, and handover between people. Sales, purchasing, warehouse, cutting, edge banding, drilling, assembly, checking, and packing teams all need the same information. That is why we start with the production order.

2. Step 1: Production Order Release

For us, production does not begin when the machine starts cutting panels. It begins when the confirmed order is released to the workshop.

For OEM orders, the production sheet is not only an internal document. It is the bridge between the buyer’s confirmed requirements and the workshop’s daily operation.

This step is sometimes overlooked by buyers, but it is one of the most important steps in OEM furniture production. If the production order is not clear, the workshop may still produce something, but it may not be exactly what the buyer approved.

A production order usually confirms:

Production Order Item

Why It Matters in Real Production

Product model / SKU

Avoids mixing different designs in the same order

Order quantity

Helps purchasing and workshop scheduling

Product size

Controls cutting, drilling, and assembly

Material

Confirms the correct board, finish, or upholstery

Color / finish

Helps reduce sample-to-bulk difference

Drawer structure

Affects cutting, drilling, slides, and assembly

Hardware

Confirms handles, knobs, slides, legs, and connectors

Smart module if needed

Confirms reserved holes and installation space

Delivery schedule

Helps the workshop arrange production time

Buyer notes

Keeps special details visible during production

This production order becomes the common language between different departments.

For example, the sales team may know the buyer wants a walnut finish with black metal legs. The purchasing team needs to know which board and edge banding to prepare. The cutting team needs the exact size. The drilling team needs hole positions. The assembly team needs the hardware. The packing team needs SKU and order information.

If these details stay only in chat messages or emails, mistakes are easy to happen. A production sheet makes the order easier to follow.

Hebai Factory Note

Before we release an OEM bedside table order to production, we check whether the main details are ready: size, material, finish, hardware, drawer structure, quantity, and special functions if included. This is not a complicated step, but it prevents many avoidable problems later.

Buyer Suggestion

Before mass production starts, we recommend buyers confirm these points with the factory:

  • final product photo or drawing;

  • size and structure;

  • material and finish;

  • drawer quantity and style;

  • handle or knob model;

  • leg or base style;

  • smart function requirement if any;

  • quantity by SKU;

  • target delivery date.

This is the first place where a buyer can reduce risk before production begins.

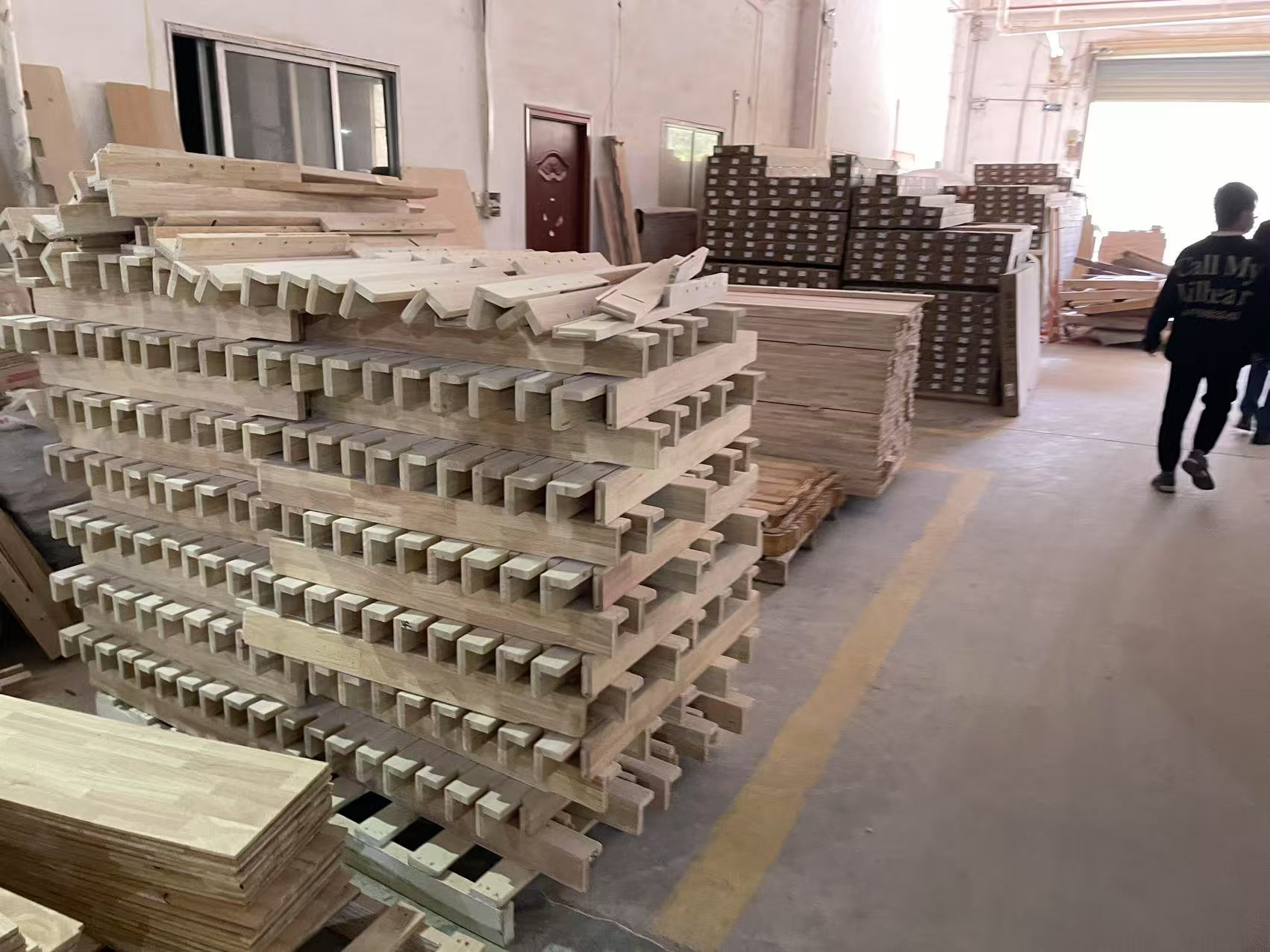

3. Step 2: Material Preparation Before Cutting

After the production order is released, the next step is material preparation.

This article is not a material comparison guide. We will not go deep into MDF, plywood, solid wood, veneer, laminate, leather, or upholstery here. That should be handled in a separate material guide.

In this production article, the main point is simple:

The factory must prepare the correct materials before cutting starts.

For a bedside table order, material preparation may include:

  • panel boards;

  • veneer, laminate, or painted surface material;

  • drawer side panels;

  • back panels;

  • edge banding;

  • drawer slides;

  • handles or knobs;

  • legs or base frames;

  • screws and connectors;

  • smart charging modules if needed;

  • labels and accessories.

The warehouse and workshop need to check whether the prepared materials match the production order. If the product uses a white finish, the edge banding must match the white finish. If the product uses black handles, silver handles should not enter the assembly line. If the product has soft-close drawers, the correct slide model must be ready before assembly.

For buyers selling into the U.S. market, composite wood products can involve formaldehyde-related requirements. EPA states that after March 22, 2019, regulated composite wood products and finished goods containing hardwood plywood, MDF, or particleboard must be labeled as TSCA Title VI compliant. CARB also regulates hardwood plywood, particleboard, MDF, and new finished goods containing these composite wood products for California-related sales.

We mention this here only because material preparation should match the buyer’s target market. It does not mean every production workflow article needs to become a compliance article. For details, buyers should check their own market requirements and confirm the material standard before placing an order.

What We Usually Check Before Cutting

Before panels move to cutting, the production team checks:

  • whether the board type matches the order;

  • whether the finish or surface direction is correct;

  • whether the board thickness is correct;

  • whether the quantity is enough for production;

  • whether edge banding color is ready;

  • whether hardware is available;

  • whether special components are separated for the order.

This step saves time later. If a missing component is found after assembly starts, the production line may have to stop.

Hebai Factory Note

For OEM bedside table orders, Hebai prepares panels, hardware, accessories, and special parts according to the confirmed production sheet. We prefer to find material problems before cutting, not after assembly.

👉For buyers who need to compare MDF, plywood, solid wood, veneer, and upholstered options before confirming production, see our bedside table material comparison guide.

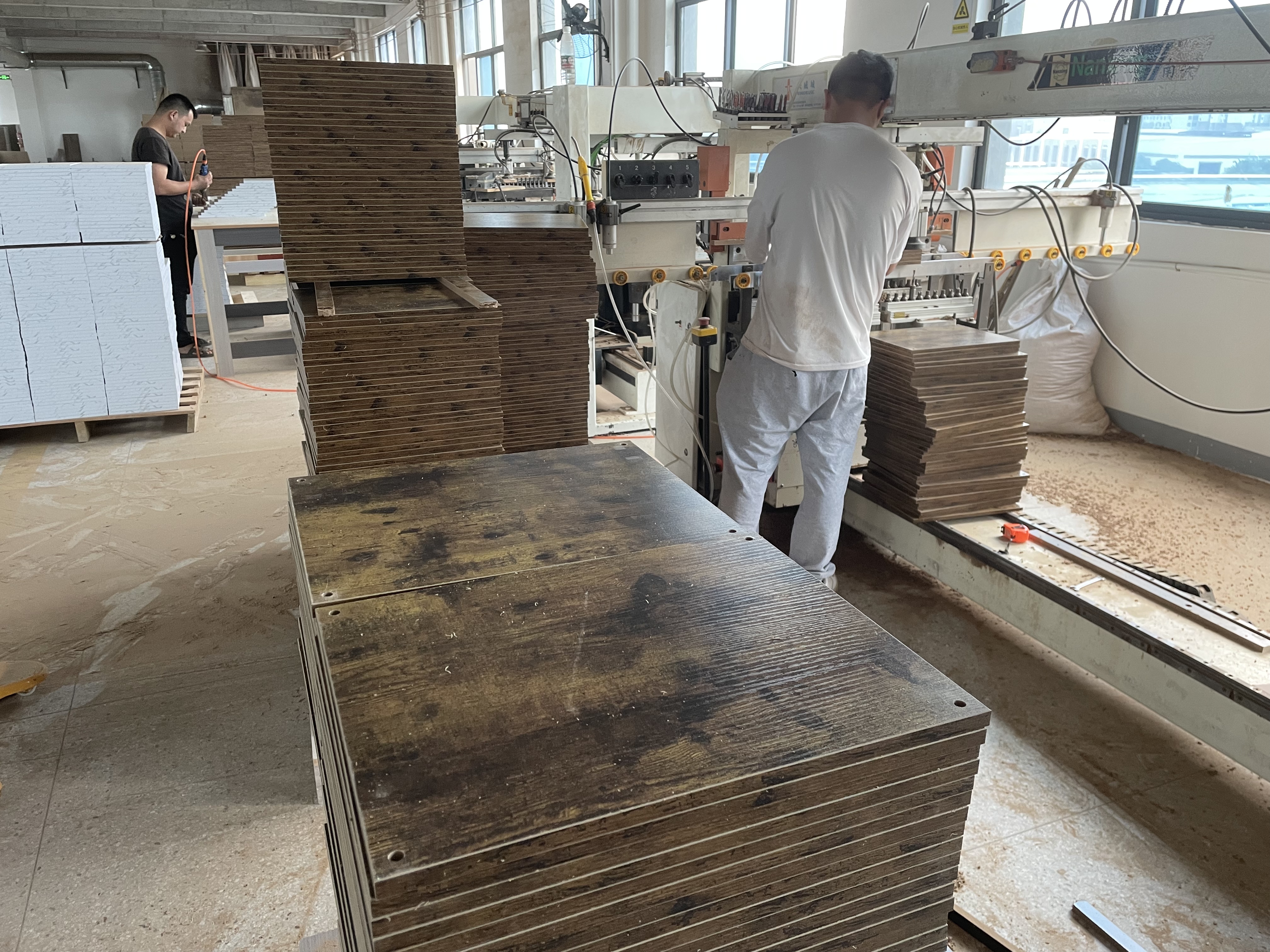

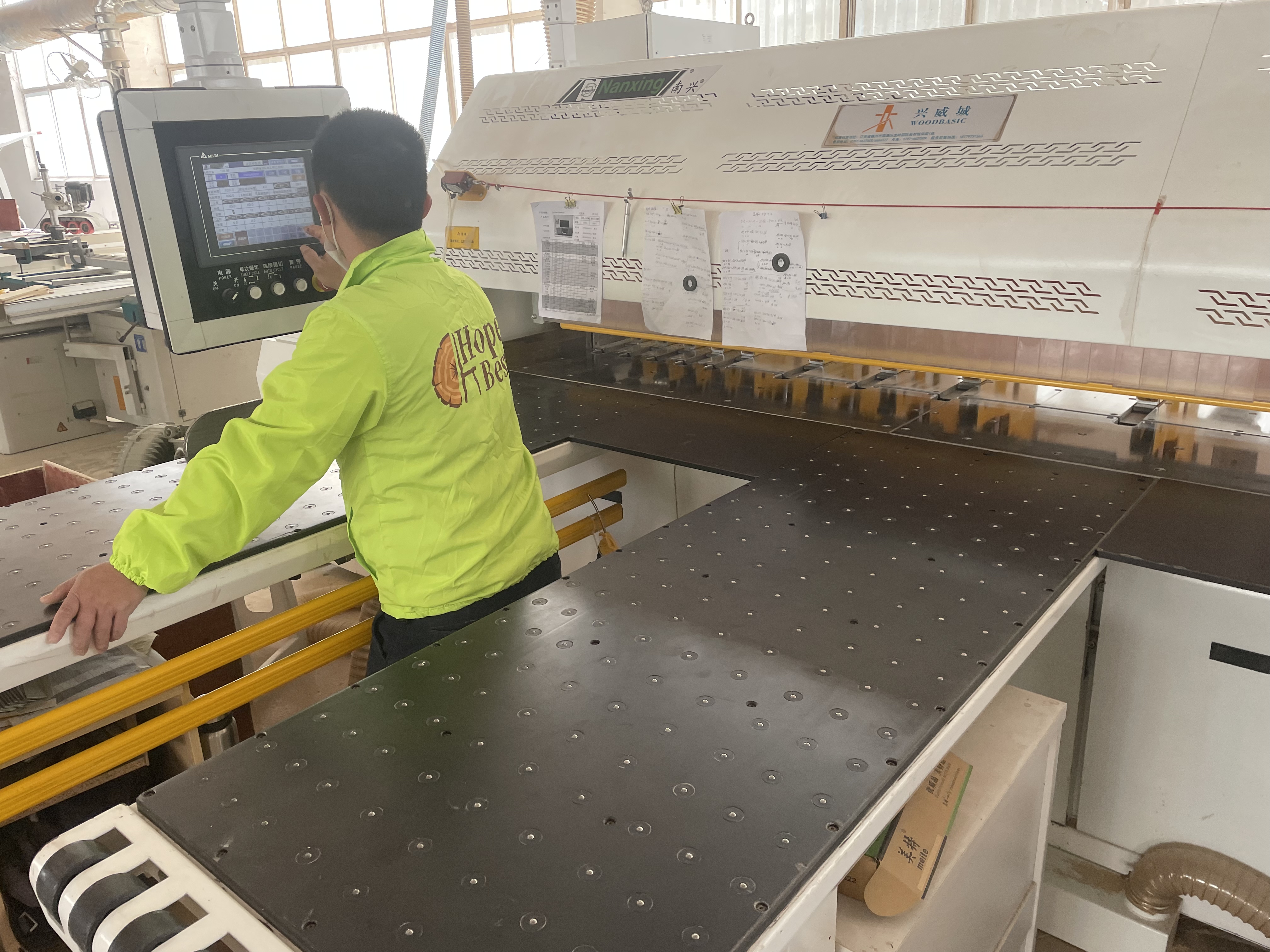

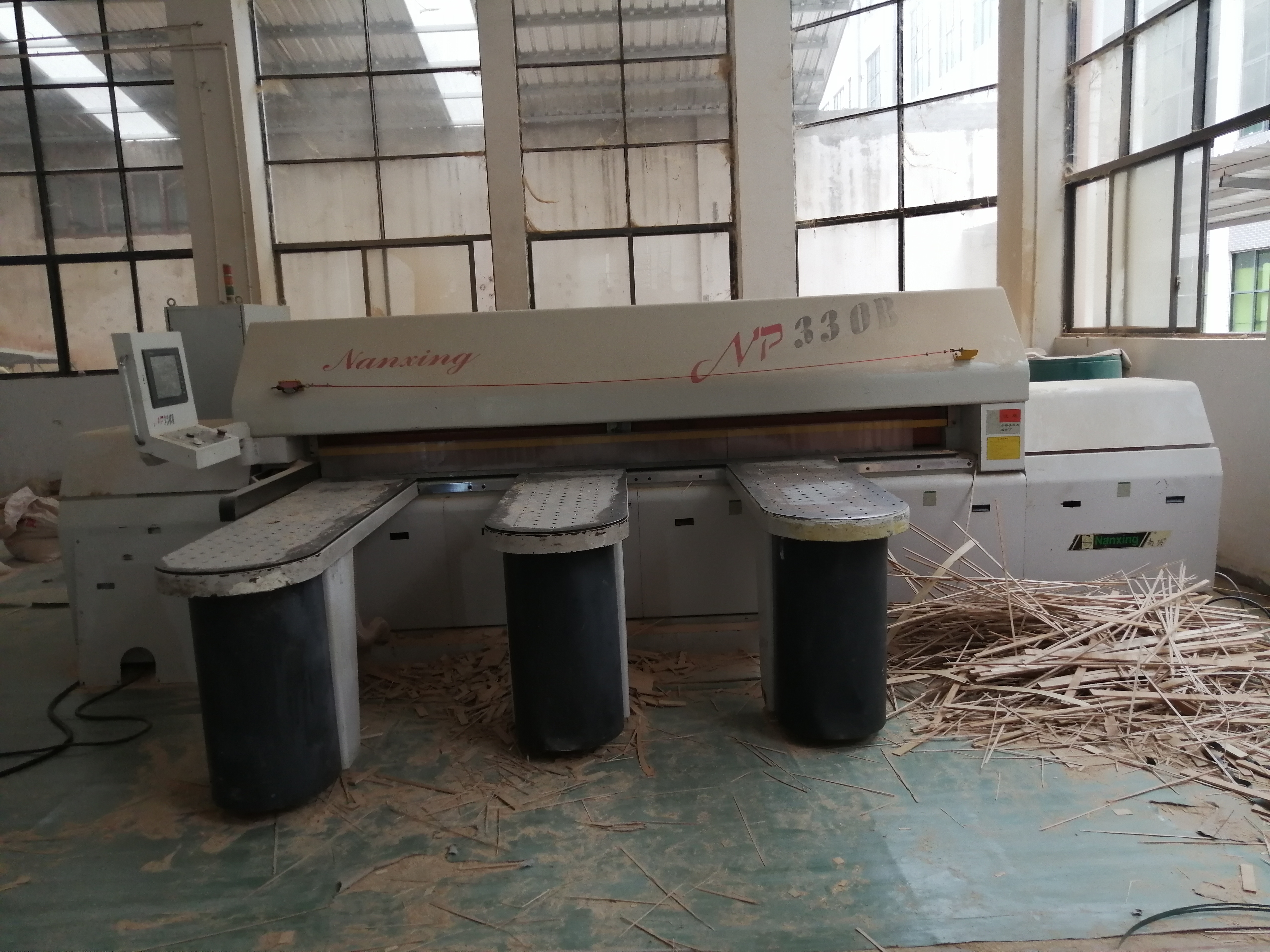

4. Step 3: Panel Cutting

Panel cutting is the first workshop step where the bedside table starts to take shape.

A large board is cut into different parts:

  • top panel;

  • side panels;

  • bottom panel;

  • back panel;

  • drawer front;

  • drawer side;

  • drawer bottom;

  • shelf panel;

  • decorative strips;

  • special shaped panels.

For a bedside table, each panel looks small, but the size must be accurate. A small error in cutting can create problems in several later steps. If the side panels are not accurate, the cabinet may not be square. If drawer fronts are not accurate, gaps may look uneven. If shelf panels are not correct, assembly may slow down.

In bulk production, this is more serious. One mistake repeated 300 times becomes a project problem, not a small workshop issue.

First-Piece Checking

Before cutting the whole batch, the factory should check the first cut parts.

The first-piece check may include:

  • length;

  • width;

  • thickness;

  • diagonal;

  • surface direction;

  • left and right panel identification;

  • SKU separation.

This step is practical. It helps the cutting team confirm that the order details have been correctly converted into production.

Component Labeling

After cutting, parts should be separated clearly. This is especially important when the same order includes several sizes or colors.

For example, a buyer may order:

  • one-drawer nightstands;

  • two-drawer nightstands;

  • open shelf bedside tables;

  • smart nightstands with USB;

  • nightstands with metal legs.

If parts are not separated, similar panels can easily be mixed. Once mixed, the mistake may not be noticed until assembly. At that point, the cost of correction is higher.

Hebai Factory Note

At Hebai, panel cutting follows the confirmed size and structure. We pay attention to first-piece checking and component separation because these small steps make bulk production easier to control.

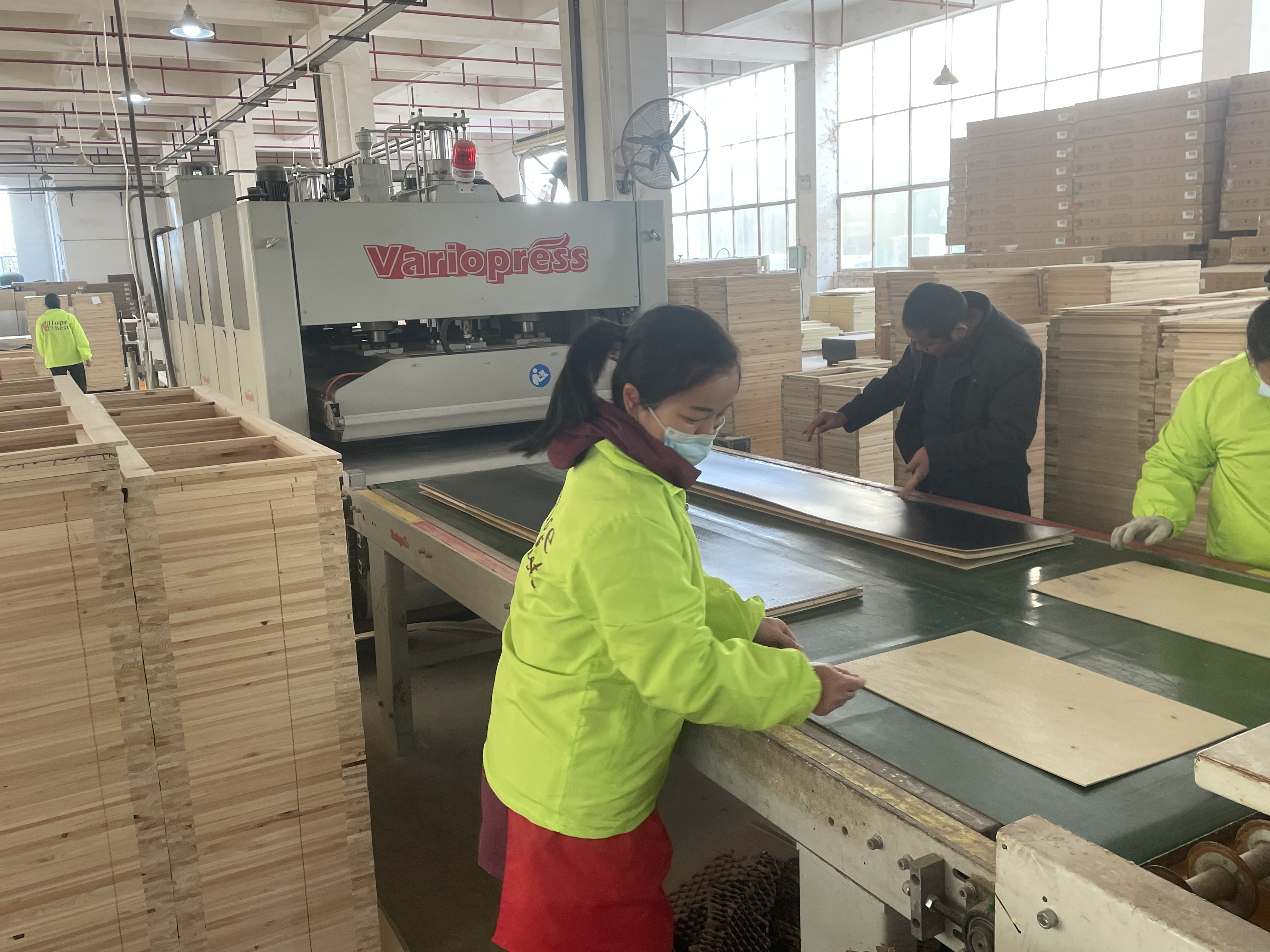

5. Step 4: Edge Banding

For panel-based bedside tables, edge banding is one of the most important visible details.

Many buyers first look at the front design, but experienced buyers often check the edges. The edge tells a lot about factory workmanship.

Edge banding covers exposed panel edges. It makes the product look more finished, improves touch feeling, and helps protect panel edges during use.

In bedside table production, edge banding may be applied to:

  • top panels;

  • side panels;

  • drawer fronts;

  • shelves;

  • cabinet bottoms;

  • exposed decorative panels.

What We Check During Edge Banding

During production, the workshop should check:

  • whether the edge banding color matches the panel;

  • whether the glue line is clean;

  • whether trimming is smooth;

  • whether corners feel safe to touch;

  • whether there is peeling;

  • whether there are visible gaps;

  • whether the surface is damaged after trimming.

A bedside table may be used every day. People touch the drawer front, top surface, and side edges often. If the edge is rough or peeling, the buyer will notice it quickly.

Why Edge Banding Should Not Be Rushed

Edge banding looks like a simple machine process, but it needs the correct material, machine setting, glue control, trimming, and checking. When production is rushed, edge problems are easy to appear.

For B2B buyers, edge banding quality affects not only appearance but also customer confidence. A buyer may not know the exact machine process, but they can see and feel a bad edge immediately.

Hebai Factory Note

During OEM bedside table production, Hebai checks edge banding before parts move to drilling or assembly. If an edge is not clean, it is better to correct it at this stage than after the product is assembled.

6. Step 5: Drilling, Slotting and Hardware Positioning

After cutting and edge banding, the parts move to drilling and slotting.

This step decides how the bedside table will be assembled.

Drilling and slotting may include:

  • drawer slide holes;

  • handle holes;

  • connector holes;

  • shelf support holes;

  • back panel grooves;

  • leg mounting holes;

  • reserved cable holes;

  • openings for USB, socket, or LED modules if required.

This step needs accuracy. If the hole position is wrong, the product may still be assembled, but it may not work properly.

Common Problems from Wrong Hole Position

Problem

Possible Workshop Cause

Drawer does not slide smoothly

Slide holes are not aligned

Handle looks crooked

Handle holes are not centered

Cabinet is not square

Connector holes are not accurate

Leg is unstable

Leg mounting holes are inconsistent

Shelf is uneven

Shelf support holes are not level

Smart module cannot fit

Reserved opening is wrong

These are not only appearance problems. They affect daily use.

Left and Right Panel Control

Many bedside table parts look similar. Left and right side panels can easily be confused if the workshop does not label them clearly. Once the wrong panel goes into assembly, the product may need to be taken apart and reworked.

Smart Function Preparation

If the bedside table includes USB charging, wireless charging, LED lighting, socket panels, or speaker modules, the factory must prepare the correct reserved position. The smart system itself should be explained in a smart nightstand guide, but the production team must still know where the module will be installed.

Hebai Factory Note

For OEM nightstands, Hebai checks hardware positions against the production sheet. For smart bedside table designs, reserved openings and internal space are reviewed before the product moves further into assembly.

7. Step 6: Surface Handling Before Assembly

Before assembly, the factory should check and handle visible surfaces.

This step is simple but important. Some problems are easier to fix before assembly. Once panels are assembled into a cabinet, some areas become hard to reach.

Surface handling may include:

  • cleaning panel dust;

  • checking scratches;

  • checking stains;

  • checking color difference;

  • checking surface direction;

  • removing small burrs;

  • separating damaged parts;

  • checking painted or coated parts;

  • checking upholstered or wrapped parts if included.

Why This Step Matters

A bedside table is not only judged by structure. Buyers also care about the surface.

A product may have correct size and strong assembly, but if the drawer front has scratches or the color direction is inconsistent, the buyer may still reject it.

For project orders, surface consistency is even more important. If many units are placed in the same hotel, apartment, or showroom, small differences become more visible.

Surface Direction

For wood grain, veneer, laminate, or similar decorative surfaces, direction matters. If one drawer front goes vertical and another goes horizontal by mistake, the finished product may look inconsistent.

This is why surface checking should happen before assembly, not only at the end.

Hebai Factory Note

Hebai checks visible surfaces before assembly to reduce rework. For OEM orders, we want surface problems to be found while the parts are still easy to handle.

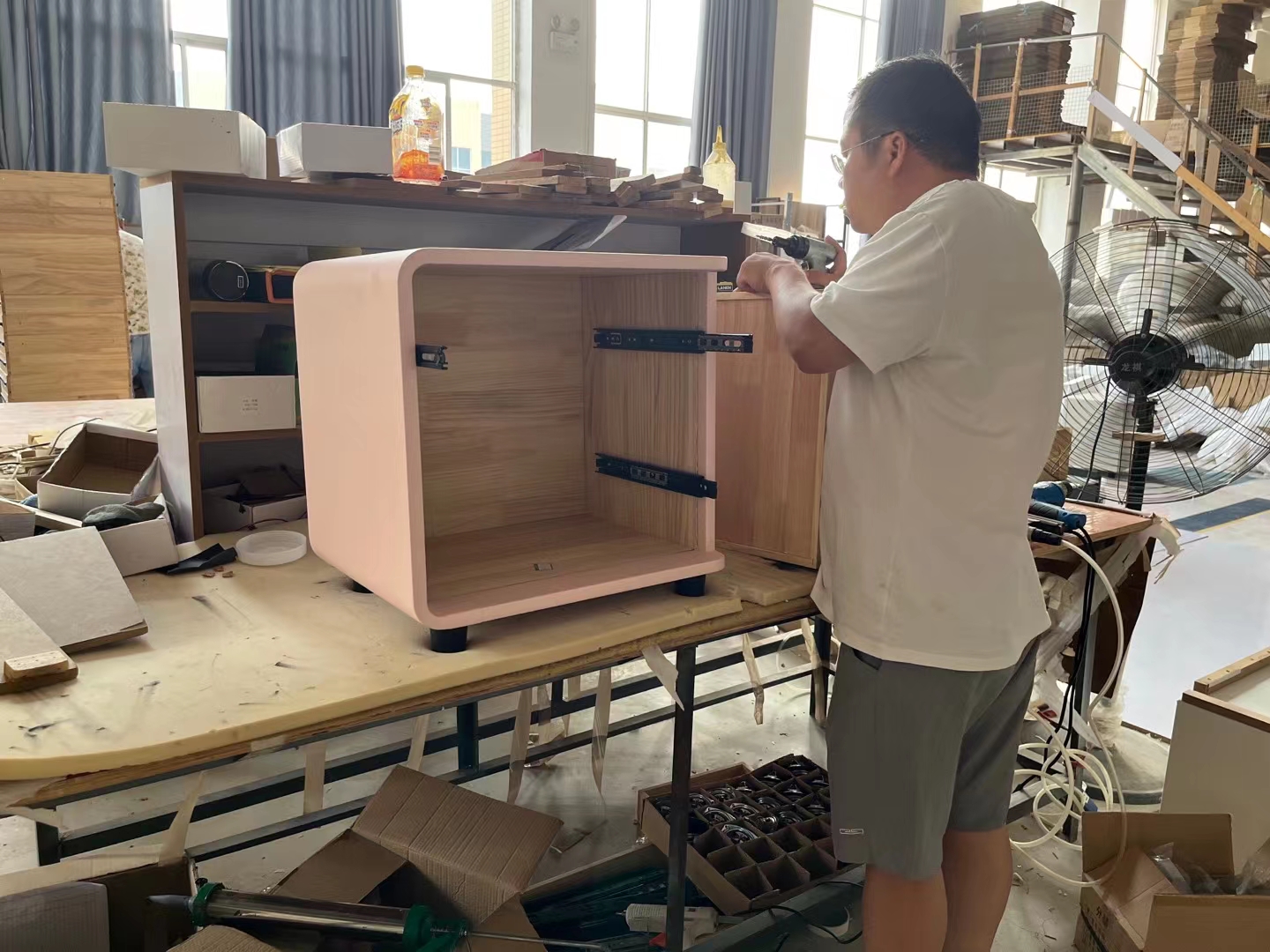

8. Step 7: Cabinet Body Assembly

Cabinet body assembly is where separate panels become the main structure of the bedside table.

The exact assembly process depends on the product design, but it usually includes:

  • side panel assembly;

  • top panel fixing;

  • bottom panel fixing;

  • back panel installation;

  • shelf installation if required;

  • connector tightening;

  • leg or base preparation;

  • structure alignment;

  • squareness checking.

A simple open shelf bedside table may be assembled quickly. A two-drawer bedside table with metal legs, soft-close slides, and a smart charging panel needs more careful sequencing.

What the Workshop Checks During Cabinet Assembly

During cabinet assembly, workers need to check:

  • whether the parts belong to the correct SKU;

  • whether connectors are tight;

  • whether the cabinet body is square;

  • whether the back panel sits correctly;

  • whether there are visible gaps;

  • whether the structure feels stable;

  • whether the surface is damaged during assembly.

For some non-domestic furniture projects, buyers may refer to standards such as EN 15372 for strength and durability requirements. In daily factory production, however, the first practical step is to keep the cabinet structure square, stable, and repeatable.

Why Structure Matters

A bedside table may be small, but it is used every day. It holds lamps, phones, books, cups, chargers, and personal items. Drawers are opened and closed repeatedly. If the structure is weak or not square, the problem may show up after delivery.

Hebai Factory Note

At Hebai, cabinet assembly follows the confirmed production sheet. Workers follow the same structure, hardware position, and assembly sequence to support repeatable OEM production.

9. Step 8: Drawer Assembly and Adjustment

Drawers deserve their own section because many bedside table complaints come from drawers.

A bedside table may have one drawer, two drawers, or one drawer with an open shelf. The structure may look simple, but drawer function is very important for user experience.

Drawer assembly usually includes:

  • drawer side assembly;

  • drawer bottom installation;

  • drawer front fixing;

  • slide installation;

  • handle or knob installation;

  • drawer insertion;

  • gap adjustment;

  • push-pull checking;

  • closing position checking.

Common Drawer Issues

Drawer Issue

Possible Production Cause

Uneven drawer gap

Cutting or assembly deviation

Drawer is hard to pull

Slide position problem

Drawer front is not aligned

Adjustment not completed

Handle is crooked

Drilling position error

Drawer does not close fully

Slide or structure misalignment

Drawer feels loose

Connector or slide installation issue

For B2B buyers, drawer consistency matters. Customers may not check the inside structure, but they will open the drawer. If it feels tight, noisy, or uneven, they will notice.

Drawer Gap Adjustment

Drawer gaps should be visually balanced. Different designs may have different gap standards, but the final look should be clean and consistent.

A drawer front that is slightly higher on one side can make the whole product look poorly made, even if the material is good.

Hardware Matching

Drawer slides, handles, screws, and other parts must match the confirmed production order. If similar hardware from another project is mixed into the order, assembly problems can appear quickly.

Hebai Factory Note

Hebai checks drawer movement, slide position, handle position, and drawer front alignment during production. We prefer to adjust drawers before the finished product moves to cleaning and packing handover.

10. Step 9: Optional Smart Module Installation

Some OEM bedside tables include smart functions.

These may include:

  • USB-A charging;

  • USB-C charging;

  • wireless charging;

  • LED lighting;

  • touch control;

  • socket panel;

  • Bluetooth speaker;

  • cable management.

This article does not go deep into smart nightstand engineering. That topic should have its own article because it involves module selection, wiring layout, power supply, user experience, and market requirements.

Here we only explain where smart modules fit into the factory workflow.

When Smart Modules Are Installed

Smart modules are usually installed after the main cabinet structure is ready and before the product moves into final checking and packing handover.

The exact timing depends on:

  • product structure;

  • internal wiring route;

  • module size;

  • panel opening position;

  • installation access;

  • buyer specification.

👉 Best Smart Nightstand Manufacturer in China | OEM Smart Bedside Table Supplier

Why the Position Must Be Planned Early

Even if the module is installed later, the reserved hole and internal space must be prepared earlier. If the opening is wrong, the panel may need to be reworked. If wiring space is not planned, the module may be difficult to install.

That is why the drilling and slotting team must understand whether the product includes smart functions before assembly starts.

Basic Function Check

After installation, the factory usually performs a basic function check, such as:

  • power connection;

  • light response;

  • charging response;

  • switch response;

  • visible module position.

This is not a full electrical engineering discussion. It is a production handover step.

Hebai Factory Note

Hebai supports OEM smart bedside table production. During workflow planning, we review smart module position, opening size, installation sequence, and basic function checking according to the confirmed product design.

👉 For detailed USB-C, wireless charging, LED lighting, module layout, and smart nightstand structure, read our smart bedside table engineering guide.

11. Step 10: In-Process Checks Before the Next Stage

In-process checking means the factory checks key points during production instead of waiting until all products are finished.

This is not the same as a full quality control system. A complete QC guide should explain IQC, IPQC, FQC, OQC, AQL, inspection reports, and third-party inspection. In this article, we only focus on the checking that happens between production stages.

The basic idea is simple:

Before one stage moves to the next, the factory should make sure it is ready.

Typical In-Process Checks

During bedside table production, the workshop may check:

  • whether cut panels match the size;

  • whether edge banding is clean;

  • whether drilling holes are correct;

  • whether surfaces are damaged;

  • whether cabinet assembly is square;

  • whether drawer movement is smooth;

  • whether handles and legs are aligned;

  • whether smart modules fit correctly;

  • whether accessories match the order;

  • whether finished products are ready for cleaning and labeling.

Why It Reduces Rework

Finding problems early is always easier than fixing them late.

For example:

  • wrong cutting size should be found before edge banding;

  • edge banding defects should be found before assembly;

  • drilling errors should be found before hardware installation;

  • drawer slide problems should be found before product handover.

This is not complicated. It is basic factory discipline.

Hebai Factory Note

Hebai uses stage-by-stage checking during OEM bedside table production. The goal is to catch problems earlier and keep the workflow organized before finished products move to packing handover.

👉 For detailed inspection standards, read our bedside table quality control guide.

12. Step 11: Cleaning, Labeling and Transfer to Packing Area

After assembly and in-process checking, finished bedside tables are cleaned, labeled, and transferred to the packing area.

This section is not a full export packaging guide. We only explain what happens before the product enters packing.

Finished Product Cleaning

Before packing handover, workers clean visible dust, fingerprints, small residue, and workshop dirt.

Cleaning may include:

  • top surface cleaning;

  • drawer front cleaning;

  • handle cleaning;

  • leg cleaning;

  • inner drawer cleaning;

  • shelf cleaning;

  • removing temporary marks;

  • checking visible stains.

A clean product is easier to inspect and pack. It also helps the packing team avoid sealing dust or residue inside the package.

Accessory Matching

Before packing, the factory should check whether the correct accessories are ready.

Accessories may include:

  • screws;

  • handles;

  • assembly parts;

  • instruction sheet;

  • smart module user notes if required;

  • spare parts if agreed;

  • product labels;

  • carton labels for packing use.

SKU and Order Separation

If the buyer orders several SKUs, finished products should be separated clearly.

For example:

  • white one-drawer bedside table;

  • walnut two-drawer bedside table;

  • black metal leg version;

  • smart charging version.

If these are not separated before packing, carton labels and order handover may become confusing.

Transfer to Packing Area

Once finished products are cleaned and matched with the order, they move to the packing area. The packing team then follows the agreed packing method.

Detailed export packaging, LCL/FCL packing, e-commerce packaging, pallet loading, and container loading should be explained in a separate export packaging guide.

Hebai Factory Note

Hebai transfers finished bedside tables to the packing area after cleaning, labeling, and order matching. This helps keep the handover clear before packing begins.

13. Application Scenarios: Who Needs a Clear Bedside Table Production Workflow?

Different B2B buyers care about different details, but all of them need one thing: stable production.

A clear workflow helps different buyers in different ways.

13.1 Furniture Brands

Furniture brands care about consistency.

When a brand approves a sample, they expect the bulk order to look the same. The finish, drawer gap, handle position, leg style, and overall structure should match the approved product.

For brands, a clear workflow helps control:

  • sample-to-bulk consistency;

  • repeat order stability;

  • private label production;

  • product line expansion;

  • hardware and finish consistency.

A brand does not want every order to feel like a new experiment. It needs repeatable production.

13.2 Importers and Wholesalers

Importers and wholesalers usually buy in larger quantities and sell to different customers.

They care about:

  • stable quantity;

  • SKU separation;

  • consistent structure;

  • fewer customer complaints;

  • repeatable production;

  • clear product handover.

For these buyers, production workflow affects warehouse efficiency and after-sales pressure.

If products arrive with mixed labels, wrong accessories, or inconsistent drawer function, the buyer may spend extra time solving problems after delivery.

13.3 Apartment Furniture Projects

Apartment projects often need many units with the same appearance and size.

A clear workflow helps control:

  • product dimensions;

  • finish consistency;

  • drawer function;

  • accessory matching;

  • project schedule;

  • room-to-room consistency.

If the production workflow is not stable, installation teams may face delays or inconsistent room appearance.

13.4 Hotel Furniture Buyers

Hotel bedside tables need practical structure and consistent appearance.

Hotel buyers may care about:

  • stable cabinet structure;

  • smooth drawer movement;

  • surface consistency;

  • hardware alignment;

  • repeatable order quality;

  • product matching between rooms.

This article does not replace a hotel bedside table buying guide. It only explains why the internal factory workflow matters after the order is confirmed.

For buyers working on hotel furniture projects, our hotel bedside tables buying guide explains project selection, specification, and sourcing considerations in more detail.

👉 Hotel Bedside Tables Buying Guide 2026

13.5 E-commerce Furniture Sellers

Online sellers need products that match photos and customer expectations.

They care about:

  • consistent appearance;

  • correct accessories;

  • fewer assembly complaints;

  • stable repeat orders;

  • lower return risk;

  • better customer reviews

For online sellers, a small production mistake can become a visible review problem.

13.6 Smart Nightstand Buyers

Smart nightstand buyers need woodworking and module installation to work together.

The workflow must consider:

  • reserved openings;

  • internal wiring space;

  • module installation stage;

  • basic function checking;

  • finished product handover.

The detailed electrical structure belongs to a smart nightstand guide, but the production workflow still needs to coordinate the smart module installation point.

14. How Hebai Keeps OEM Bedside Table Production Organized

Hebai Furniture supports OEM and ODM bedside table production for furniture brands, wholesalers, importers, apartment projects, hotel furniture buyers, and smart nightstand buyers.

We know buyers care about price, but price is not the only thing that decides whether an order goes well. A smooth order also depends on clear information, prepared materials, organized workflow, and practical checking during production.

Our Production Workflow Focus

For OEM bedside table orders, Hebai focuses on:

  • confirmed production sheet;

  • material preparation before cutting;

  • workshop scheduling;

  • component separation;

  • panel cutting;

  • edge banding;

  • drilling and hardware positioning;

  • cabinet body assembly;

  • drawer assembly and adjustment;

  • optional smart module installation;

  • in-process checking;

  • finished product cleaning;

  • labeling and transfer to packing area.

Why Buyers Work With a Factory Like This

A clear workflow helps buyers reduce:

  • production misunderstanding;

  • wrong material use;

  • assembly mistakes;

  • mixed SKUs;

  • drawer problems;

  • handover confusion;

  • repeat order inconsistency.

We do not want buyers to feel uncertain after placing an order. Our job is to turn the confirmed design into a product that can be produced, checked, cleaned, labeled, and handed over for packing in an organized way.

Send Your Design for Production Review

Have a confirmed bedside table design but not sure whether it is ready for bulk production?

Send your drawing, reference photo, size, quantity, material, finish, hardware, and target market. Hebai Furniture can review the structure, production workflow, hardware position, smart module location if needed, and practical manufacturing details before mass production.

15. OEM Bedside Table Production Checklist for Buyers

Before production starts, buyers can use this checklist to reduce misunderstanding.

Checklist Item

Buyer Should Confirm

Product model

Final design, SKU, or reference image

Product size

Width, depth, height, drawer size

Material

Panel, surface finish, upholstery if any

Color / finish

Approved sample or color reference

Drawer structure

One drawer, two drawers, open shelf, cabinet door

Hardware

Handles, knobs, slides, legs, connectors

Smart functions

USB, wireless charging, LED, sockets if required

Quantity

Total quantity and SKU breakdown

Production timeline

Expected lead time and delivery plan

Labeling

SKU label, product label, order label if needed

Packing handover

Basic requirement before export packing

This checklist does not replace technical drawings or formal order documents. But it helps buyers and factories speak clearly before production begins.

Want to reduce production misunderstanding before placing a bulk order?
Request our OEM Bedside Table Production Checklist to confirm size, material, hardware, finish, smart module position, labeling, and packing handover details before production starts.

FAQ: Bedside Table Factory Production Process

1. What happens after an OEM bedside table order is confirmed?

After the order is confirmed, the factory releases the production order, checks the approved specification, prepares materials, arranges the cutting plan, schedules workshop capacity, and prepares hardware and accessories for production.

2. Why is production order release important?

Production order release makes sure the workshop follows the confirmed size, material, color, hardware, quantity, and delivery plan. It reduces misunderstanding between sales, purchasing, warehouse, production, and checking teams.

3. What is the first workshop step in bedside table production?

The first workshop step is usually material preparation. The factory checks whether panels, hardware, drawer slides, legs, handles, and other parts match the confirmed production requirements.

4. Why is panel cutting important for bedside table production?

Panel cutting decides whether the top, side panels, drawer fronts, shelves, and back panels fit correctly during assembly. Poor cutting accuracy can lead to uneven gaps, unstable structure, and slow assembly.

5. What does edge banding do in bedside table manufacturing?

Edge banding covers exposed panel edges, improves appearance, protects the edges, and creates a smoother touch. It is especially important for panel-based bedside tables.

6. Why does drilling accuracy matter?

Drilling accuracy affects drawer slides, handles, legs, shelves, and assembly holes. If holes are not positioned correctly, drawers may not move smoothly and hardware may not align properly.

7. What is checked during bedside table assembly?

During assembly, workers check cabinet structure, drawer movement, hardware position, drawer gaps, leg balance, surface appearance, and whether all parts match the production order.

8. When are smart modules installed in smart bedside tables?

Smart modules are usually installed after the main cabinet structure is completed and before the final product handover. The exact timing depends on product design and internal wiring layout.

9. What does in-process checking mean?

In-process checking means the factory checks important points during each production stage instead of waiting until all products are finished. This helps find problems earlier and reduce rework.

10. What happens before bedside tables move to the packing area?

Before packing, finished bedside tables are cleaned, visually checked, labeled, matched with accessories, and transferred to the packing area according to the order and SKU.

11. Why is drawer adjustment important in bedside table production?

Drawer adjustment affects how the user experiences the product. If drawer gaps are uneven or the slide position is not correct, the product may look poorly made even when the material is acceptable.

12. Can the same production workflow be used for different bedside table designs?

The main workflow is similar, but each design may require different cutting lists, drilling positions, hardware, assembly sequence, smart module placement, and finished product checking points.

13. How can buyers help the factory avoid production mistakes?

Buyers can provide clear drawings, product photos, dimensions, material requirements, finish references, hardware details, quantity breakdown, and target market requirements before production starts.

14. Is a production workflow useful for repeat orders?

Yes. A clear workflow helps the factory repeat the same size, structure, hardware position, drawer movement, and appearance in future orders. This is important for brands, wholesalers, and project buyers.

15. Can Hebai review a bedside table design before production?

Yes. Buyers can send product photos, drawings, sizes, materials, finishes, quantities, hardware requirements, and smart function needs. Hebai can review the design and provide practical production suggestions before mass production.

Send Your Bedside Table Design for Production Review

Looking for a reliable OEM bedside table factory in China?

Hebai Furniture supports OEM and ODM bedside table production for furniture brands, wholesalers, importers, apartment projects, hotel furniture buyers, and smart nightstand buyers.

Send us your:

  • product photo or drawing;

  • size;

  • quantity;

  • material;

  • finish;

  • hardware requirements;

  • drawer structure;

  • smart function requirements if needed;

  • target market.

Our team can review your design and provide production suggestions, MOQ, quotation, lead time, and export-ready solutions.

👉 Ganzhou Hebai Wood Products Co., Ltd

✔Web:https://hebaifurniture.com/

✔Email:vincent@hebaifurniture.com

✔whatsapp:+86 15207972272

👉 Home| Product| Smart Bedside Table Series|Catalogue

Request OEM Bedside Table Production Review
Send your drawing, photo, quantity, material, finish, and target market. Get production suggestions, MOQ, lead time, and quotation from Hebai Furniture.

👉 Send My Design for Review

Request: OEM Bedside Table Production Checklist

Before placing a bulk order, use this checklist to confirm:

  • product size;

  • material and finish;

  • drawer structure;

  • hardware details;

  • smart module position;

  • production order information;

  • in-process checking points;

  • labeling and packing handover requirements.

👉 Get Production Checklist

Watch Our Factory Video

See how smart bedside tables are manufactured at Ganzhou Hebai Wood Products Co., Ltd.

YouTube: OEM bedside table manufacturer China

Explore Our OEM Furniture Project

Behance: Smart OEM Bedside Table Manufacturing System | Hotel Furniture Supplier in China

Read Industry Insights

Medium: Why Global Buyers Are Choosing OEM Bedside Table Manufacturers in China in 2026

Connect on LinkedIn

LinkedIn: Why OEM Bedside Table Manufacturing in China Is Evolving Rapidly in 2026
